UL-Listed vs UL-Recognized: What Enclosure Buyers Should Verify
An essay-style guide explaining why “UL Listed” is not enough, helping buyers understand UL 50E vs. UL 508A and ask which part of the enclosure

Why I Always Ask One More Question When Someone Says “It’s UL Listed”
UL 50E vs UL 508A Explained for Control Panel Buyers
Years ago, I also thought “UL Listed” was a complete answer.
I have made the same assumption myself. A buyer asked for a UL-listed control panel. The supplier replied that the enclosure was UL listed. At first, I thought the buyer had simply asked the wrong question. Later, I realized the supplier had answered a different question.
The buyer was not careless. The supplier was not necessarily trying to mislead anyone either. They were simply talking about two different things without realizing it.
That is why I now pause whenever someone says, “It’s UL listed.”

My next question is always:
Which part is UL listed?

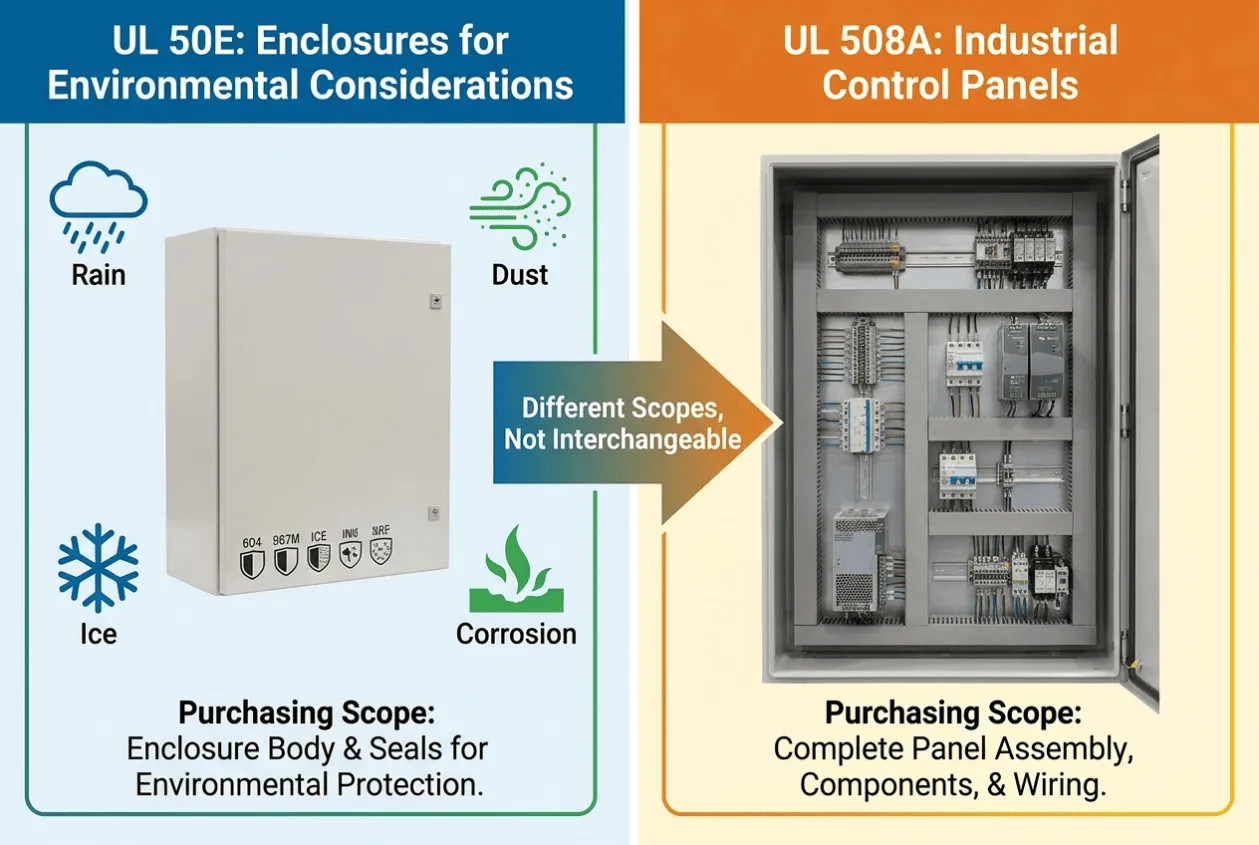

Because UL 50E and UL 508A are not the same purchasing scope. UL 50E is for enclosures for electrical equipment under environmental considerations, while UL 508A is the standard for industrial control panels.
In plain buyer language:
UL 50E checks the enclosure. UL 508A checks the assembled control panel.
This difference sounds small until the project reaches approval.

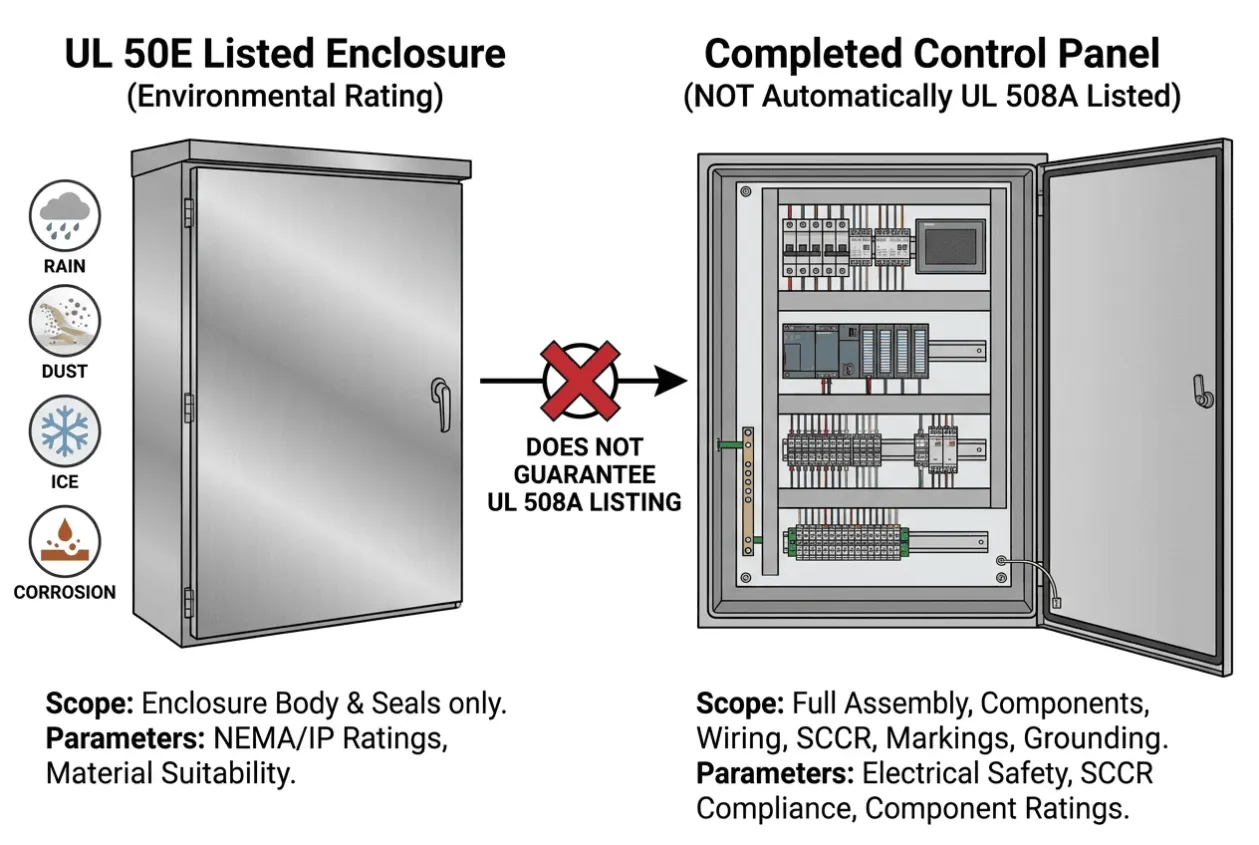

A stainless outdoor enclosure may be UL 50E listed. That does not automatically mean the completed control panel, with breakers, PLC, HMI, wiring, terminals, grounding, markings, SCCR, and internal layout, is UL 508A listed.
What Each Standard Actually Covers
UL 50E - the enclosure itself
UL 50E evaluates the empty enclosure as a product: construction, gasketing and sealing, corrosion resistance, and how the design holds its rating whether it is steel, stainless, or non-metallic. When you buy a UL 50E listed enclosure, the listing belongs to that enclosure model - and modifications such as cut-outs can affect it, which is why the file number and modification scope belong in the RFQ.
UL 508A - the assembled control panel
UL 508A is a construction standard for industrial control panels. It governs the assembled panel: component selection and spacing, wiring practices and wire sizing, grounding, short-circuit current rating (SCCR), markings, and the shop documentation behind all of it. A UL 508A panel can only be built by a shop authorized under the standard, and each build carries a UL 508A supplement label.
In short: UL 50E follows the box, UL 508A follows the build.

This is usually where the conversation changes.
Before the drawing appears, both sides think they agree. Once the panel drawing appears, they discover they were discussing different products.
After seeing this happen several times, I started making a small comparison for our buyers.
Buyer Says | Supplier May Mean | What Buyer Should Confirm |
|---|---|---|
UL-listed enclosure | The empty enclosure is listed. | Which UL file number applies? |
UL-listed panel | The complete panel is listed. | Is the assembly scope UL 508A? |
UL components inside | Components have UL marks. | Does the whole panel carry the required label? |
NEMA 4X outdoor cabinet | The enclosure rating is required. | Do accessories and cutouts keep the rating? |

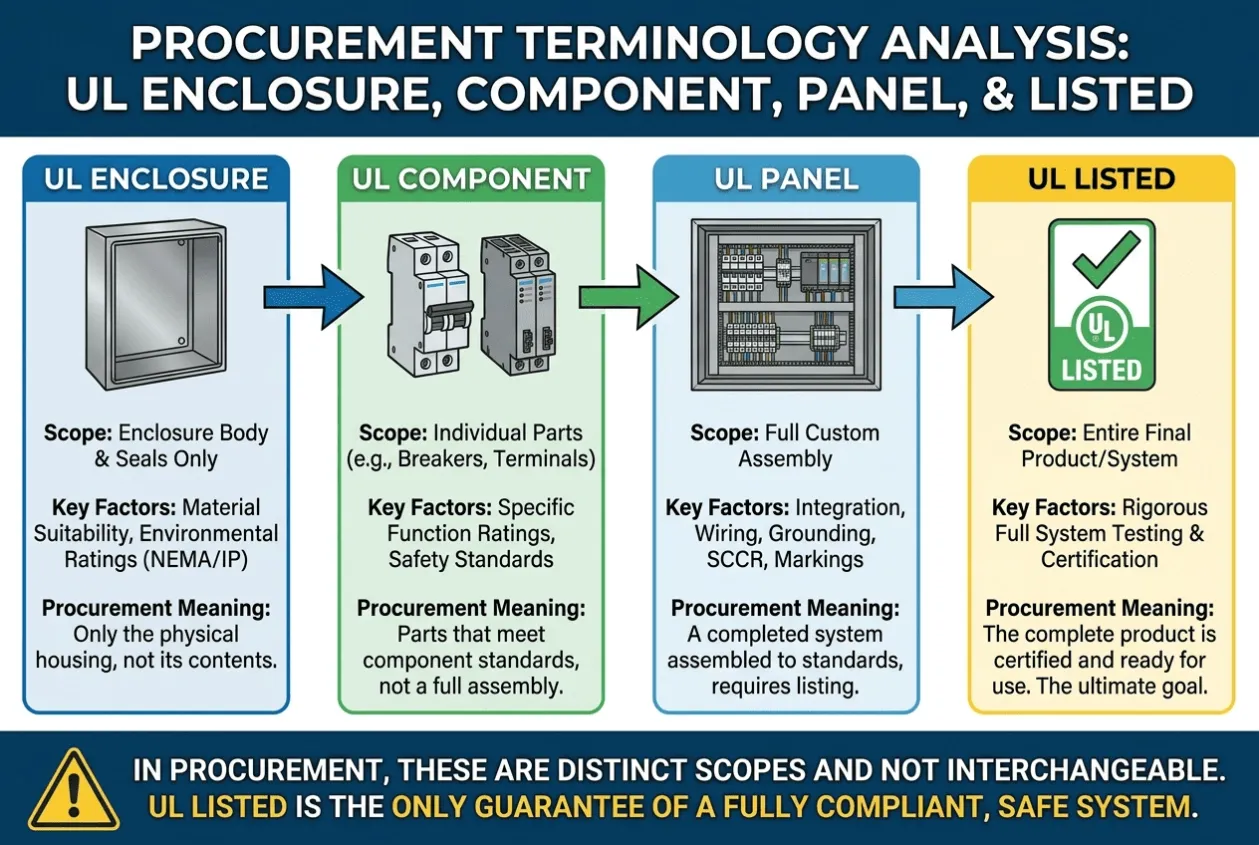

I do not think buyers confuse UL because they do not care. They confuse it because the words sound almost identical in a quotation.
“UL enclosure,” “UL component,” “UL panel,” and “UL listed” can look close on paper. In procurement, they are not close enough.

If I were writing the RFQ myself, it would probably look something like this for an enclosure-only order:
“Please quote a UL 50E Listed enclosure and provide the UL file number, material, NEMA type, accessories included, and confirmation that modifications will not affect the listed rating.”
For a complete control panel, I would write it differently:
“Please quote a UL 508A industrial control panel. Provide drawings, BOM, SCCR, markings, FAT report, label scope, and confirmation of the assembly certification before shipment.”
Not beautiful wording.
Useful wording.
At UniRegal, we do not treat “UL” as one general word. We first ask what the buyer is actually purchasing: an empty enclosure, a modified enclosure, or a complete wired control panel. For enclosure projects, we can help source UL 50E listed options. For complete panels, we work through suitable UL 508A assembly workshops where required.

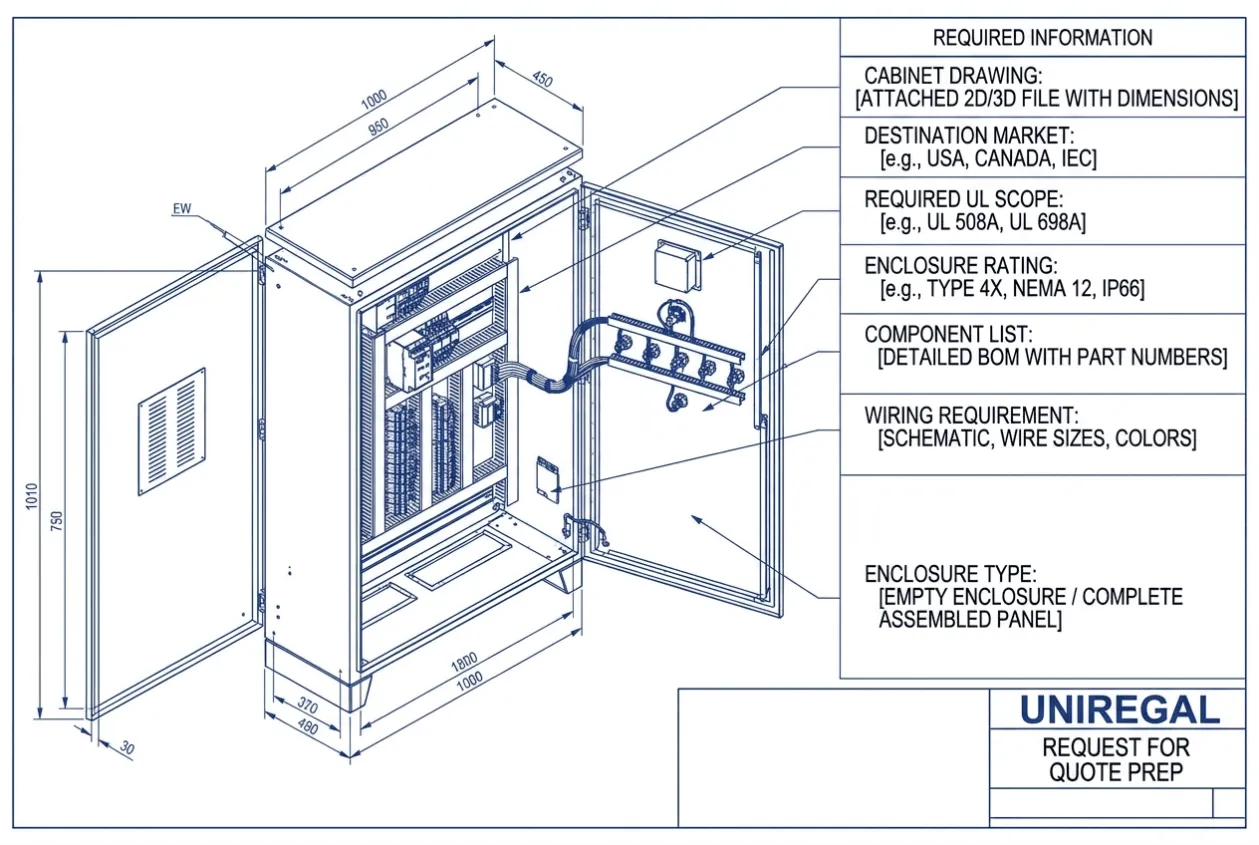

Before requesting a quote, send UniRegal your cabinet drawing, destination market, required UL scope, enclosure rating, component list, wiring requirement, and whether you need an empty enclosure or a complete assembled panel.

After enough projects, I have stopped asking:
“Is it UL?”
Now I ask:
“Which UL standard applies to exactly what I am buying?”
The answer is usually much more useful.
Every time I hear someone say, “It’s UL Listed,” I know the real conversation is just beginning.
Five Things to Check on the UL Mark
Before accepting any UL claim on a quote, five checks settle it:
- The mark names what was actually bought - enclosure, component, or assembled panel
- A file or model number is present, so the listing can be traced in UL's public database
- For a complete panel: the UL 508A supplement label is on the panel, with an SCCR rating
- For Canada-bound projects: the mark covers cUL, not just UL
- Enclosure modifications are covered by the listing scope, not just promised in an email
A supplier who hesitates at any of these five is telling you something useful before the PO is signed.
Frequently Asked Questions
Does a UL 508A panel require a UL 50E enclosure?
Not automatically. A UL 508A panel shop evaluates and documents the enclosure used in the build as part of the panel certification. But if you are buying the empty enclosure separately - or modifying it before use - then the enclosure's own UL 50E listing and modification scope become your responsibility to confirm.
Is UL certification mandatory to sell equipment in the US?
There is no federal law requiring UL for all industrial equipment. In practice, AHJs (authorities having jurisdiction), insurers, and end customers usually require a listed panel or enclosure before power-up and handover. Most projects treat it as mandatory even where the law does not.
How do I verify a supplier's UL file number?
Ask for the file number in writing, then look it up in UL's public database (UL Product iQ) and confirm the company name matches the certified company, the category matches what you are buying, and the listing is active.
UL vs cUL vs NEMA 4X - what do I actually need?
UL covers the US market, cUL covers Canada - many marks carry both. NEMA 4X is a rating for corrosion and washdown resistance, not a safety certification; a NEMA 4X enclosure is not automatically UL listed, and vice versa. State the destination market and the environment separately in the RFQ.
Related reading
What to send your supplier
Forward your rating (NEMA 4X / IP65), material (304 or 316 stainless), and whether you need a UL 50E listing or a UL 508A-listed assembly. Bring the drawing and submit your requirements — we will match a UL-listed Foshan workshop, confirm the file number, and quote with a typical 15-day enclosure lead time.
Need help specifying or sourcing this for your project? Request a quote - we reply within 1-2 working days with a technical review.
