UL Listed Electrical Enclosures: Sourcing from China Without the Factory Risk

A buyer's guide to sourcing UL listed electrical enclosures from China — what UL listing really covers, why a sourcing partner beats a single factory

UL Listed Electrical Enclosures

What “UL Listed” Actually Means for an Electrical Enclosure



When a buyer writes “UL Listed enclosure required” in an RFQ, that requirement is often less clear than it appears.
The first question should be:
Do you need the enclosure itself to carry a UL certification, or do you need the finished industrial control panel inside it to be UL 508A compliant?
Those are different requirements.

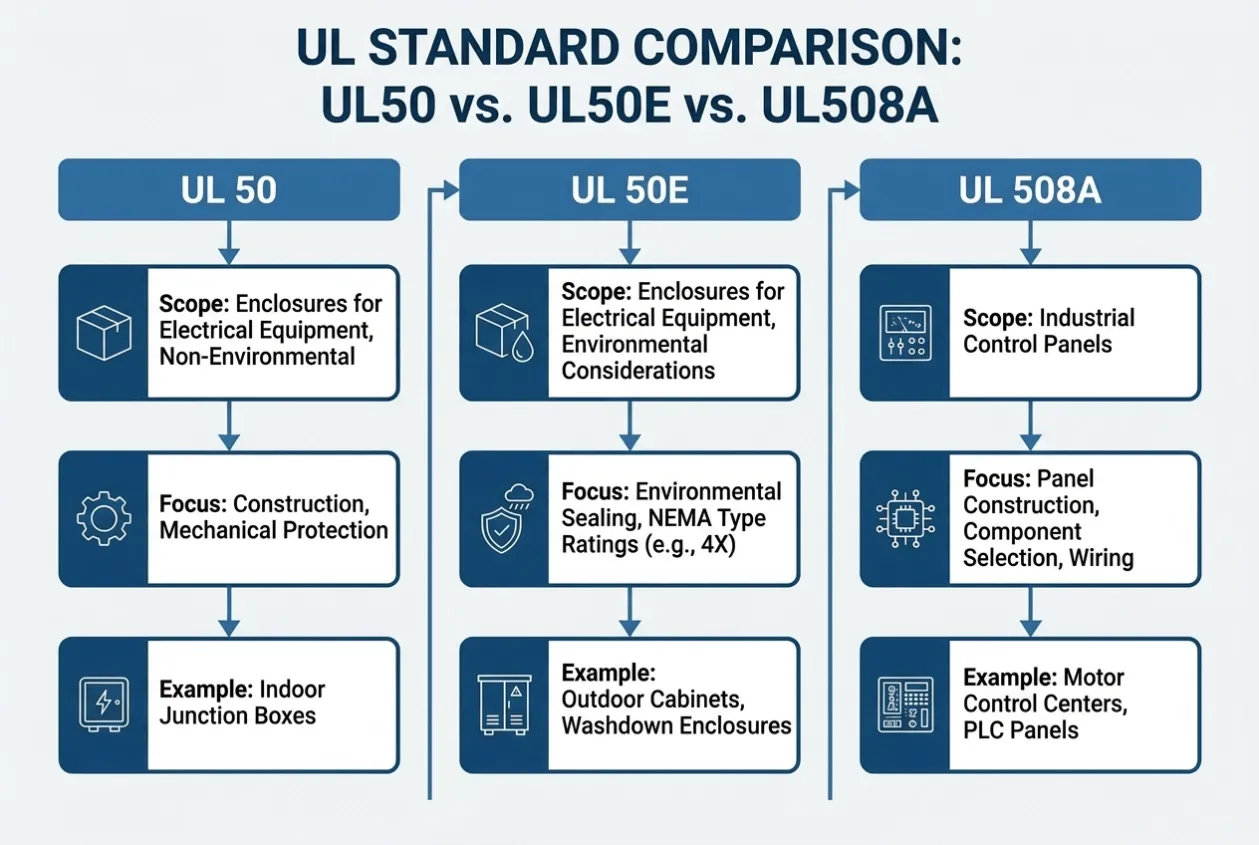

UL 50 and UL 50E[¹] address electrical enclosures and environmental construction considerations, including characteristics such as corrosion resistance and maintaining the environmental seal. UL 508A[²] applies to the assembled industrial control panel and includes requirements for the components and construction used inside that panel.


Understanding that distinction prevents one of the most common sourcing problems: receiving a supplier’s UL certificate and assuming it automatically covers the enclosure, material, NEMA Type and finished panel being quoted.

The Decision Matrix: What UL Requirement Do You Actually Need?



What You Are Buying
What to Confirm
What Buyers Often Get Wrong
Empty electrical enclosure
Certification scope for the enclosure construction and required environmental type
Assuming any UL certificate from the manufacturer covers every enclosure they make
NEMA 4X outdoor enclosure
Confirm the certified enclosure type, material, and model/construction.
Assuming stainless steel automatically means NEMA 4X
Custom enclosure with cutouts
Confirm the modified construction remains within the certification conditions.
Assuming unlimited modifications can be made to a listed enclosure
Complete PLC / VFD control panel
UL 508A requirements for the finished panel where specified
Asking only whether the empty cabinet is “UL Listed”
Complete outdoor UL 508A panel
Verify both the panel certification and the required enclosure environmental rating.
Assuming UL 508A alone determines the outdoor enclosure type
Component used inside a panel
Check whether it is listed or recognized and its conditions of use.
Treating a UL-recognized component as a finished UL-listed product
The important point is simple:
Ask for certification that matches the product you are actually buying.

A UL File Number Is Not a Company-Wide Passport

This is where buyers need to be careful.
One certified enclosure family does not automatically certify every enclosure manufactured by the same company.
A manufacturer may legitimately have a UL certification file, but that does not mean every product coming from that company can carry the UL Mark.
UL certification is tied to defined products and constructions. UL’s Follow-Up Services also identify authorized manufacturing locations and verify that certified products continue to be manufactured according to the construction covered by the certification.
So if a supplier says:
“Our factory is UL listed.”
The next question should be:
Which models, materials and enclosure Types are covered by the file you are quoting against?
That question is much more useful than asking for a certificate PDF.
UL Product iQ can be searched using information such as the file number, model, product type, or category control number, allowing buyers and engineers to verify certification information rather than relying only on a sales document.

Why Material and Construction Still Matter

Suppose a workshop has certified carbon-steel enclosures.
A buyer now requests:
316 stainless steel NEMA Type 4X Wall-mounted Custom door cutouts
You should not assume that the existing certification automatically covers that new construction.
Changing material, hardware, sealing arrangements, openings, or other construction details can affect the conditions under which the certification applies. UL specifically uses follow-up services to check that products carrying its mark remain consistent with the construction originally evaluated.
This is why the correct sourcing sequence is:
Specification first → certification scope second → quotation third.
Not the other way around.

Engineering Example: The Certificate Looked Right Until the Scope Was Checked

Consider a pump-control project requiring an outdoor stainless-steel enclosure.
The specification called for a wall-mounted stainless enclosure with NEMA Type 4X protection, and the finished assembly also needed to satisfy the project’s UL 508A requirement.
During quotation review, one workshop immediately supplied a UL file number.
Commercially, everything looked fine.
The cabinet dimensions were correct, the price was competitive, and the supplier could produce stainless-steel enclosures.
The problem appeared when the certification scope was checked.
The UL documentation presented by the supplier did not establish that the exact stainless enclosure construction being quoted was covered in the way the project required.
That changed the purchasing decision.
Instead of trying to force the project through that workshop, the enclosure had to be matched with a manufacturing source whose UL certification[³] scope supported the required construction, while the completed industrial control panel[⁴] was handled separately under the appropriate UL 508A panel requirements.
Nothing was wrong with the first workshop.
It simply did not have the right certification scope for that particular job.
That is the distinction buyers need to understand.
A genuine UL file number can still be the wrong UL file number for your project.

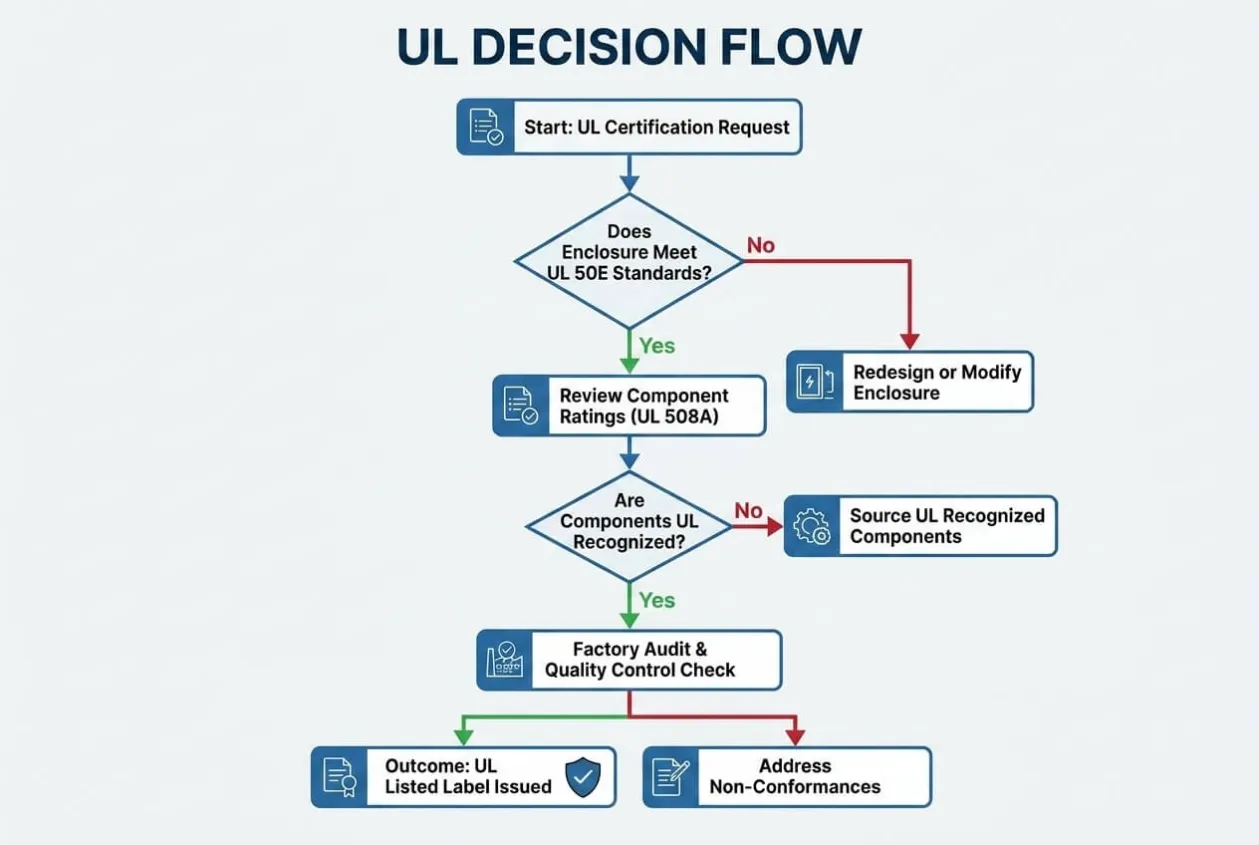

What to Check Before Approving a UL Enclosure

You do not need a twenty-item certification questionnaire.

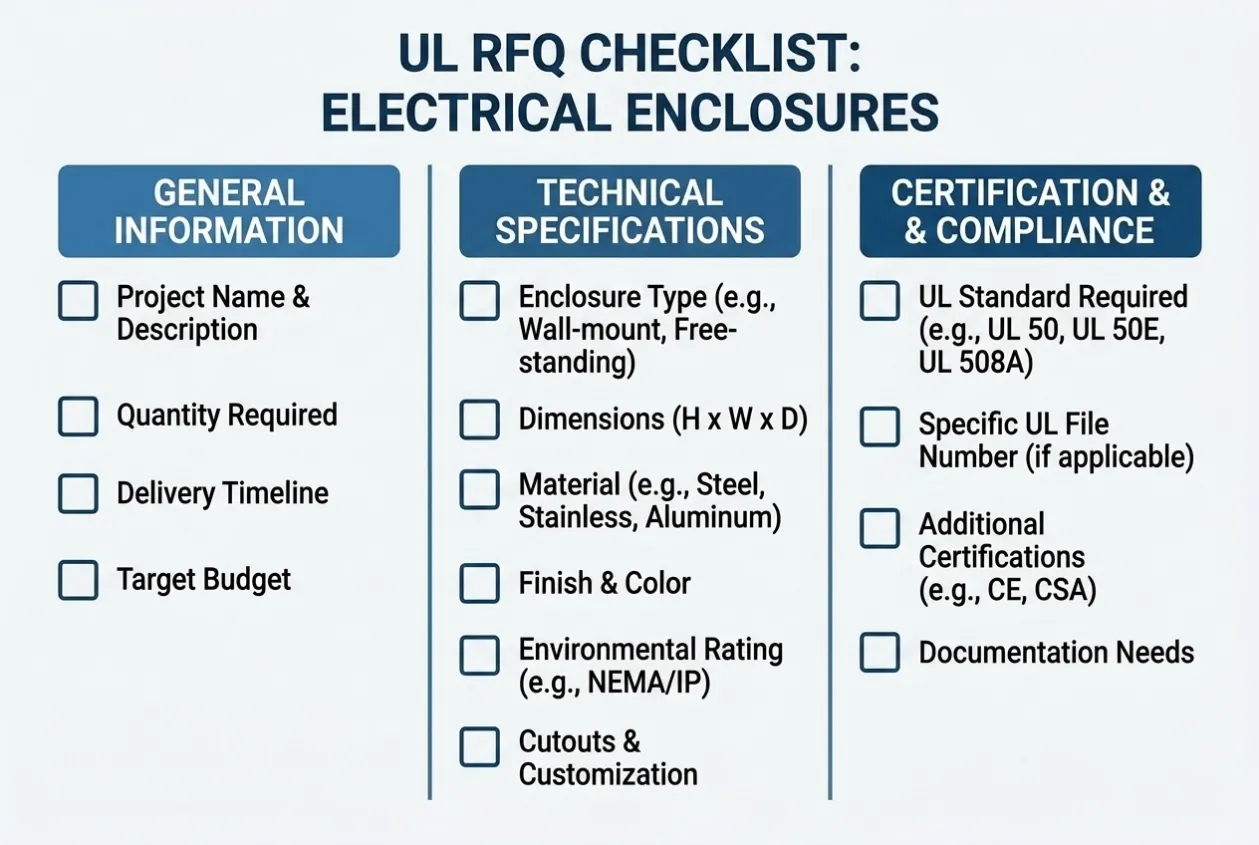

For most enclosure purchases, verify these points before placing the order:

1. What exactly carries the UL Mark?

Is it the empty enclosure, a component, or the finished industrial control panel?

2. What product construction is covered?

Check the model family, material, enclosure type, and any relevant construction limitations.

3. Is the manufacturing location authorized?

UL’s certification system includes ongoing inspections at locations authorized to manufacture products carrying the UL Mark.

4. Does your customization remain within the certification scope?

Cutouts, hardware, cooling equipment, windows, and other enclosure-mounted accessories may affect environmental performance. UL separately evaluates environmental-rated enclosure accessories because these components can affect the enclosure seal and rating.

5. Does the finished panel also require UL 508A?

If you are purchasing a complete control panel rather than an empty box, clarify this before production begins.

Common Mistakes

❌ Asking whether the factory is UL listed instead of asking whether the quoted construction is covered.
❌ Assuming one UL file covers every carbon-steel, 304, and 316 stainless enclosure produced by the same workshop.
❌ Treating UL 50/50E enclosure certification and UL 508 An industrial control panel requires the same thing.
❌ Assuming a NEMA Type 4X requirement can be proven simply by supplying a stainless-steel cabinet.
❌ Making custom cutouts or changing accessories without checking whether the environmental rating and certification conditions are still maintained.
❌ Accepting a certificate PDF without verifying the file number and product information in UL’s certification records.

Engineering Takeaway

“UL Listed” should never be treated as a general quality label attached to a supplier.
It applies to a defined certified product or construction produced under UL’s certification and Follow-Up Services system. Only products bearing the appropriate UL certification mark are identified by UL as certified products.
For an enclosure project, the safest buying question is therefore not
Do you have UL?
Ask:
Does your certification cover this enclosure material, construction and required environmental Type, and does the finished panel separately need UL 508A?
That one question will eliminate a surprising amount of confusion before production starts.

Need a UL Enclosure or Complete UL 508A Panel?

Send UniRegal your drawing, material, dimensions, required NEMA type, and whether you need an empty enclosure or a complete control panel.
We can review the requirement first and match the project to a manufacturing source whose certification scope fits the actual build, rather than forcing your specification into whatever one workshop already produces.
Send Your UL Enclosure Specification for Review
