Buying Guides
Enclosure Vibration Isolation Guide: Spec the Base Before the Cabinet Fails
A panel that passed FAT on a bench can still fail at a vibrating site. The cause is almost never the components — it's the base you didn't spec.

A control panel left a clean bench fully functional and came back from site with a loose terminal, a cracked HMI mount, and a drive throwing intermittent faults. The components didn't wear out—the base did. Vibration isolation is one of the most skipped specs in our RFQs, and it's one of the cheapest ways to stop a panel from self-destructing on a vibrating skid.
We build panels to the isolation level the site demands; we're a sourcing partner, so this is about getting the base right before the cabinet ships, not selling you a heavier box.

The real reason panels fail at vibrating sites
Vibration does three things in order: it loosens every connection that wasn't torqued and lock-washed, it fatigues thin sheet-metal mounts until they crack, and it walks an un-isolated enclosure across the floor until a conduit pulls. None of these show up in a static FAT. They show up at hour 400 on a compressor skid.
The trap is thinking, "The enclosure is steel; it's fine." Steel doesn't absorb vibration—it transmits it. Without isolation, you've bolted your sensitive electronics directly to the thing trying to shake them apart.
Cause → fix, by failure mode
Failure mode | Root cause | What actually fixes it |
|---|---|---|
Loose terminals after weeks | No vibration-grade termination | Spring-cage or lock-washer + torque check |
Cracked HMI / door mount | A thin panel transmits resonance. | Isolate the whole enclosure, not just the mount. |
Intermittent drive faults | PCB solder joints fatigued | Reduce transmitted amplitude below the fatigue threshold. |
Conduit pull-out | Enclosure walks on the floor. | Base isolation + flexible conduit drop |
Notice the pattern: the fix is almost never "buy a better component." It's "stop the energy reaching the component."
Picking the isolator
Site condition | Isolation approach | Why |
|---|---|---|
Light buzz (HVAC, small pumps) | Rubber foot pads | Kills high-frequency chatter |
Reciprocating machinery (compressors) | Spring or elastomer mounts | Handles larger amplitude |
Impact / frequent starts | Wire-rope isolators | Damps shock, not just steady vibration |

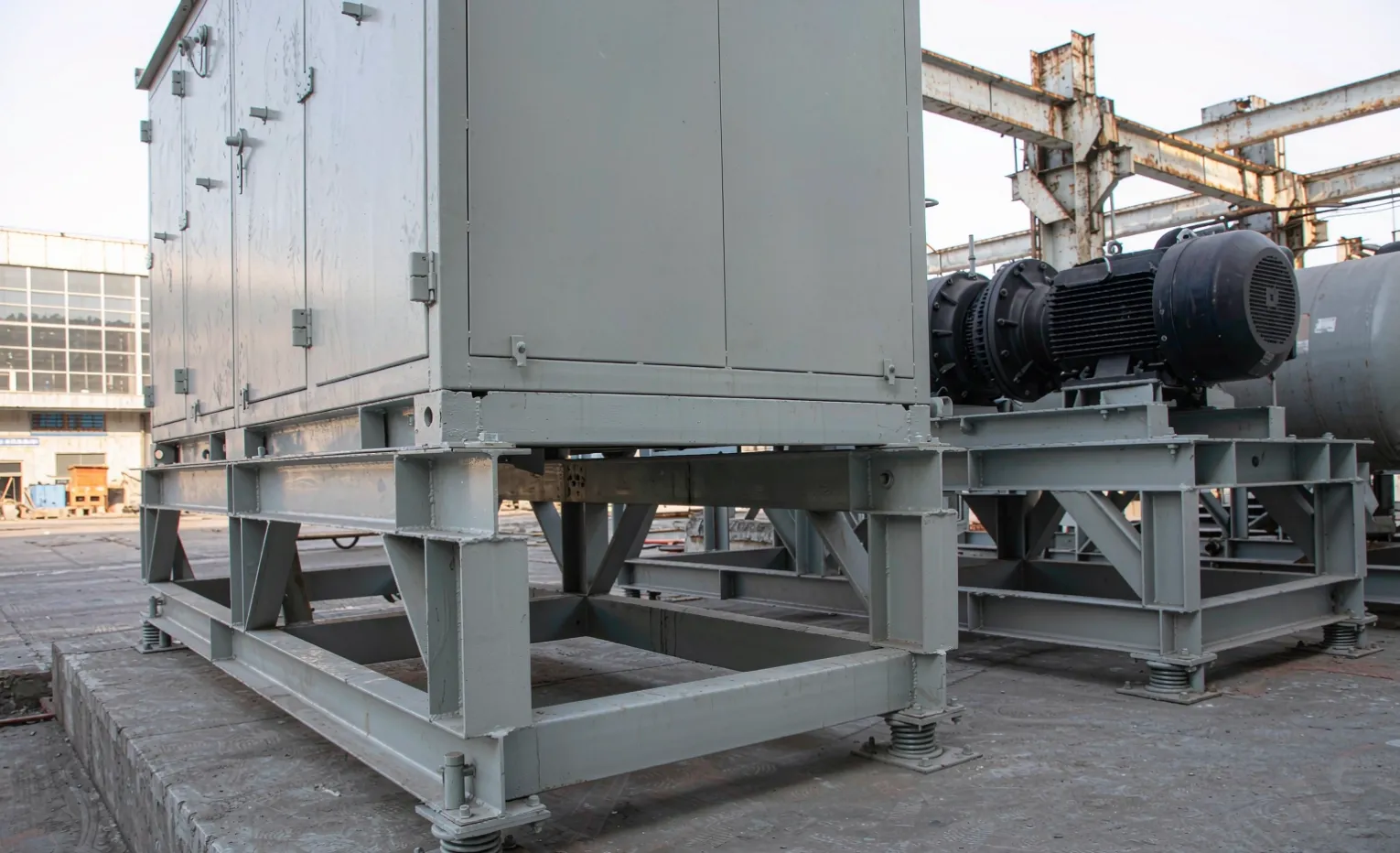

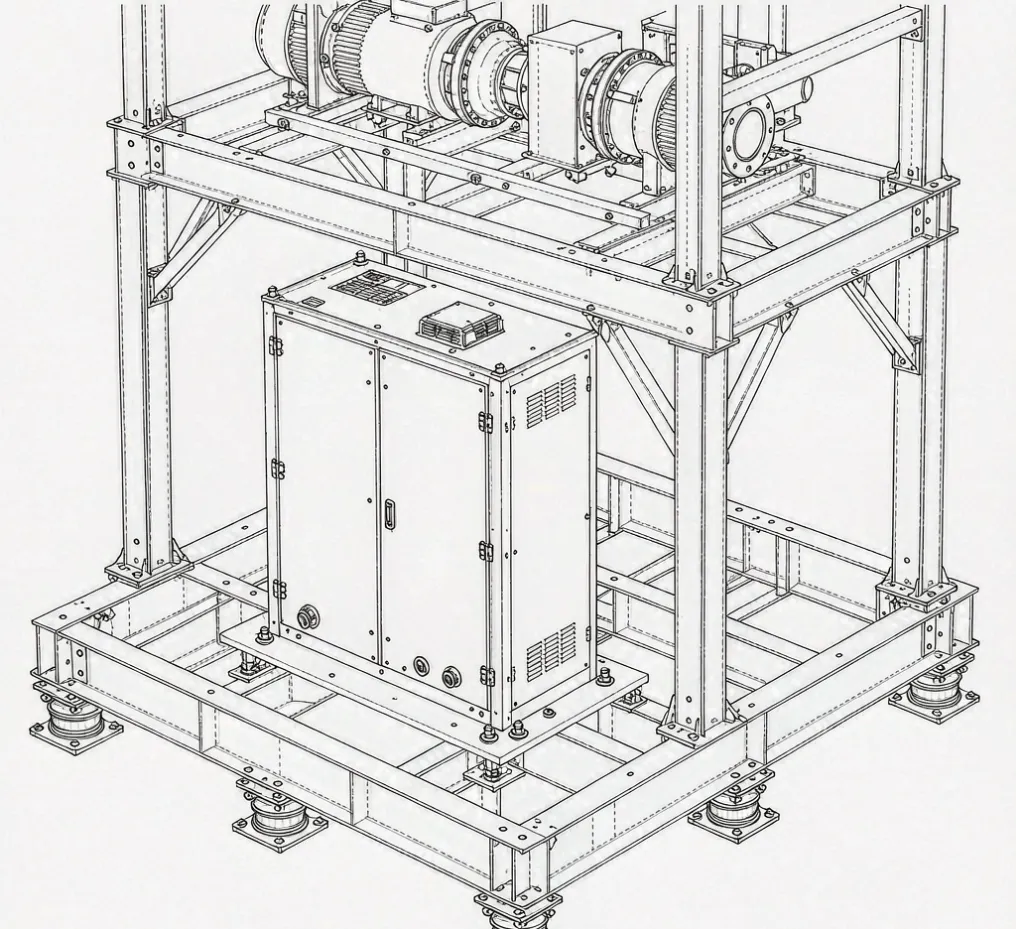

Mobile / skid-mounted | Base-frame isolation | Stops the whole unit walking |
A quick rule: match the isolator's natural frequency to be well below the dominant site frequency (usually you want the isolator at 1/3 to 1/2 of the disturbing frequency). An isolator tuned to the wrong range can amplify vibration instead of killing it.

What we do at the build stage
Even with perfect isolators, a panel that's going to vibrate needs internal discipline—and for sites that require certified enclosures, the references we build to are IEC 60068-2 for vibration endurance and IEC 60529 for ingress. We work for them; we don't write for them.
- Termination: spring-cage terminals or properly torqued bolted connections; never rely on friction fit.
- Mounting: secure HMI and heavy devices to a sub-panel, not the thin door skin.
- Routing: Strain-relieve every cable where it enters so vibration can't work it loose at the gland.
- Weight: keep the center of gravity low so the isolated enclosure doesn't tip into resonance.

The check you can do before shipment
If your site vibrates, ask the builder one question: what's the transmitted amplitude at the device level, not just at the floor? A panel can look isolated from outside and still transmit enough to fatigue a drive. We document the isolation scheme on the drawing so your site team can verify it was built as specified.
Field checklist (tick before you accept the panel)
- [ ] Isolator type matches the site frequency range, not just "rubber feet"
- [ ] Heavy devices on a sub-panel, not the door
- [ ] All terminations are vibration-rated and torqued
- [ ] Cables strain-relieved at every entry point
- [ ] Flexible conduit used where the panel connects to fixed piping
- [ ] Isolation scheme shown on the released drawing

FAQ
Do I need isolation for a panel in a climate-controlled room?
Only if there's a local vibrating machine nearby. A quiet room with no machinery usually doesn't need it.
Will isolator pads alone stop a cracked HMI mount?
If the HMI is mounted on the thin door and the whole enclosure still transmits resonance, no. Isolate the enclosure base and mount the HMI on a rigid sub-panel.
How do I know the dominant site frequency?
For rotating machinery, it's roughly RPM ÷ 60. For reciprocating compressors, it's 2 × RPM ÷ 60. That gets you close enough to pick an isolator range.
Can I just bolt the panel harder to stop movement?
Bolting transfers vibration straight into the steel. You need to absorb it, not clamp it.
Do wire-rope isolators need maintenance?
They're largely maintenance-free but should be inspected for broken strands after major shock events.
